Worked example

Project Management Prompts Example: One Company, All 10 Prompts

Corbel sells scheduling and dispatch software to heating, air-conditioning and plumbing contractors. Its last major release, Dispatch 3.0, was due on 9 March 2026 and shipped on 25 May: 11 weeks late, $1.66M against a $1.2M budget, with 9 of its 41 pilot customers rolling back. Now the CEO has told the board that technicians will be able to work offline by the end of Q1 2027. Corbel has 14 engineers and 212 requests in its backlog.*

$31Mannual revenue from 640 heating, air-conditioning and plumbing contractors
11 weekslate on Dispatch 3.0, which also ran 38% over budget
22%of Dispatch 3.0 pilot customers rolled back to the old version
41%of cancellation surveys in the last year name working offline

Prompt 01 · Discover

Business Case: How Corbel Used It

What Corbel brought · CFO

“The board has heard “offline” for a year. Before it approves anything, it wants to know what it costs and what we get back.”

What the prompt returned

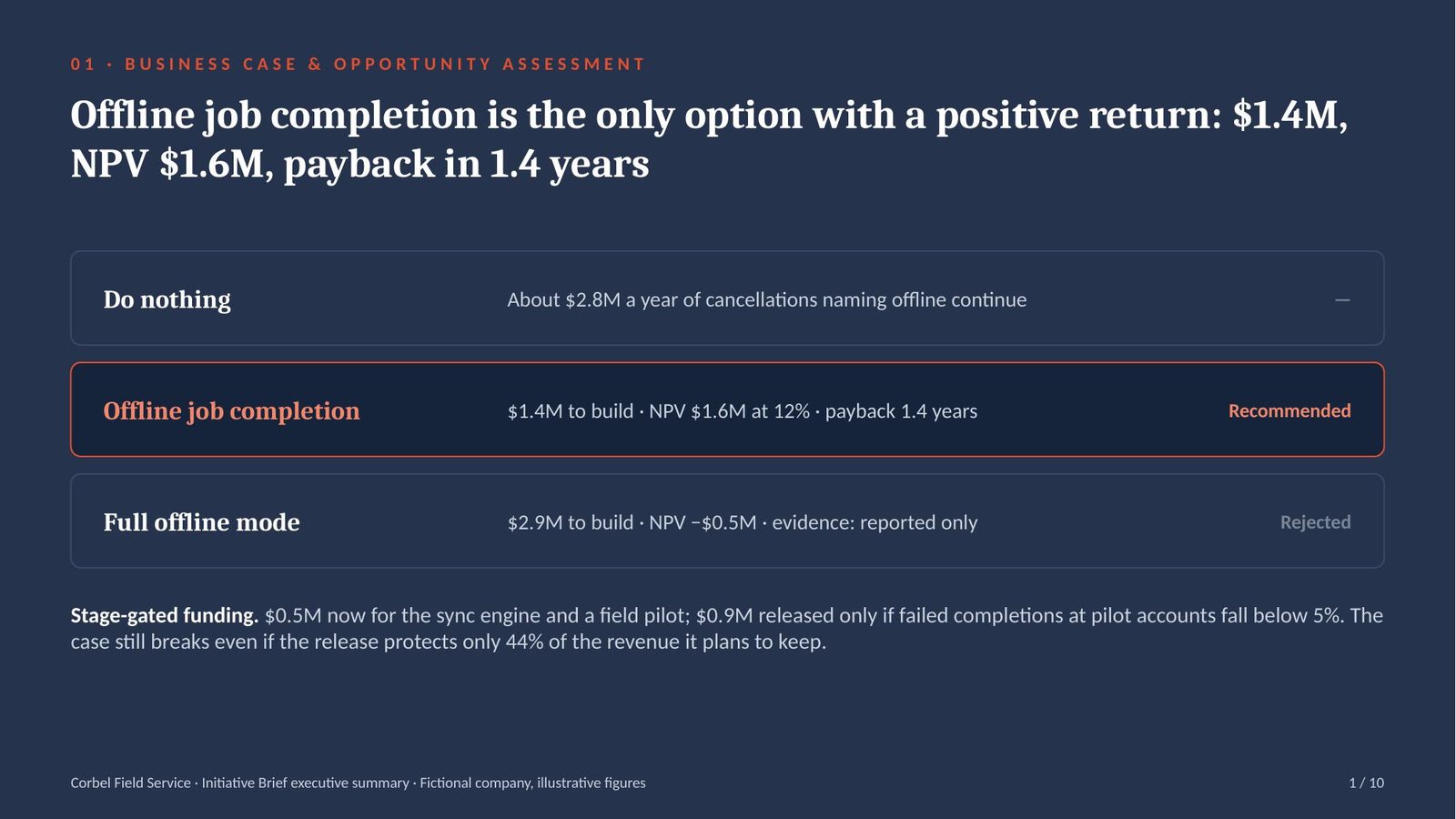

Fund offline job completion: $1.4M, net present value $1.6M at 12%, payback in 1.4 years. Full offline mode costs $2.9M and has a negative net present value.

Do nothing
about $2.8M a year of cancellations continue
Offline job completion
$1.4M, NPV $1.6M, payback 1.4 years
Full offline mode
$2.9M, NPV −$0.5M, evidence Reported only
Funding request
$0.5M now, $0.9M after the pilot gate

Takeaway: approve $1.4M for offline job completion in two stages. The case still breaks even if the release protects only 44% of the revenue it plans to keep.

The analysis · Offline job completion is the only option with a positive return

A business case compares the options for solving a problem, including doing nothing, on their costs, benefits and risks, and ends with a funding request. Net present value (NPV) converts future cash flows into today’s money at the required return, 12% at Corbel, and payback is the time needed to recover the investment.

  • The cost of the problem: 48 of 118 cancellation surveys in the last year named offline working, from accounts paying $2.8M a year, and 19% of job completions fail at 170 commercial accounts.
  • The recommended option: offline job completion costs $1.4M to build and $0.2M a year to run. From 2028 it protects $1.4M of revenue and saves $0.3M of support costs a year: an NPV of $1.6M over three years and payback in 1.4 years.
  • Stage-gated funding: the budget is released in stages. $0.5M funds the sync engine and a field pilot; the remaining $0.9M is released only if failed completions at pilot accounts fall below 5%.

Prompt 02 · Define

Requirements Document (BRD and PRD): How Corbel Used It

What Corbel brought · Engineering lead

“Last time we got a slide and a date. Tell us what ‘offline’ means before you ask us to estimate it.”

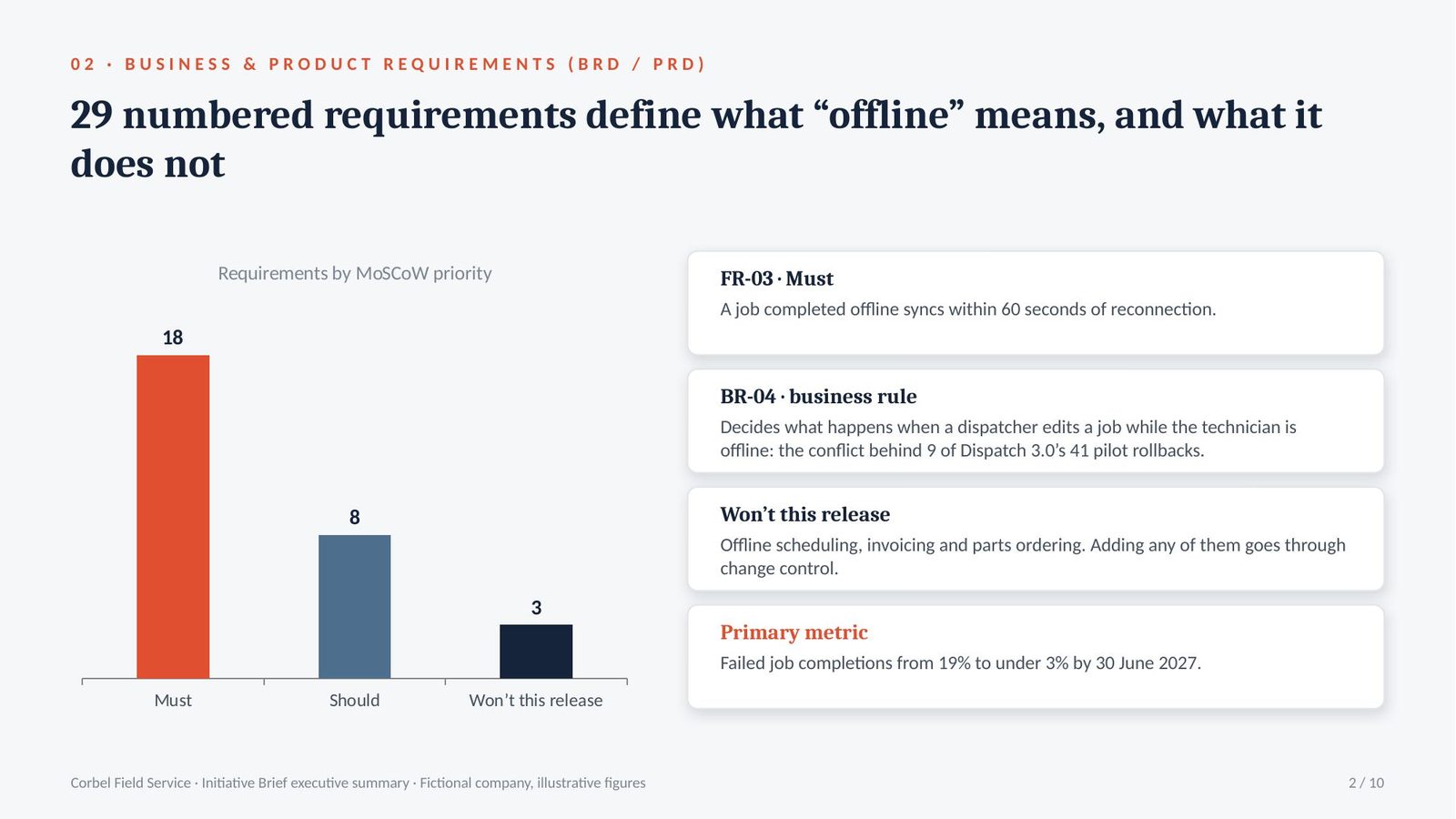

What the prompt returned

29 numbered requirements: 18 Must, 8 Should, 3 Won’t this release. FR-03: a job completed offline syncs within 60 seconds of reconnection. Scheduling, invoicing and parts ordering stay online.

Requirements
7 business rules, 22 functional, 7 non-functional
FR-03 · Must
offline job syncs within 60 seconds of reconnection
Business rule added
BR-04: dispatcher edits a job while the technician is offline
Primary metric
failed completions from 19% to under 3% by 30 Jun 2027

Takeaway: give every requirement an ID, a priority, a source and an acceptance test, and start measuring sync time before the build, because there is no baseline today.

The analysis · Numbered requirements with sources control the scope growth that delayed Dispatch 3.0

A business requirements document (BRD) lists what a system must do as numbered requirements, each with a priority, a source and an acceptance test, so IT or a vendor can build and test against it; a product requirements document (PRD) covers the same ground as user stories for a product team. Dispatch 3.0 had neither: it started with 14 user stories and finished with 31.

  • MoSCoW priority: each requirement is marked Must, Should, Could or Won’t this release. Offline scheduling, invoicing and parts ordering are recorded as Won’t, so adding any of them later goes through change control.
  • Business rules: the conditions the system must enforce. BR-04 decides what happens when a dispatcher edits a job while the technician is offline, the kind of data conflict behind 9 of Dispatch 3.0’s 41 pilot rollbacks.
  • Traceability matrix: a table that links each business objective to its requirements, and each Must requirement to its acceptance test, so every Must requirement serves the business case and can be tested.

Prompt 03 · Define

Project Charter: How Corbel Used It

What Corbel brought · Chief Operating Officer

“On Dispatch 3.0, three people could add scope and nobody could say no. I don’t want to find out who owns this in February.”

What the prompt returned

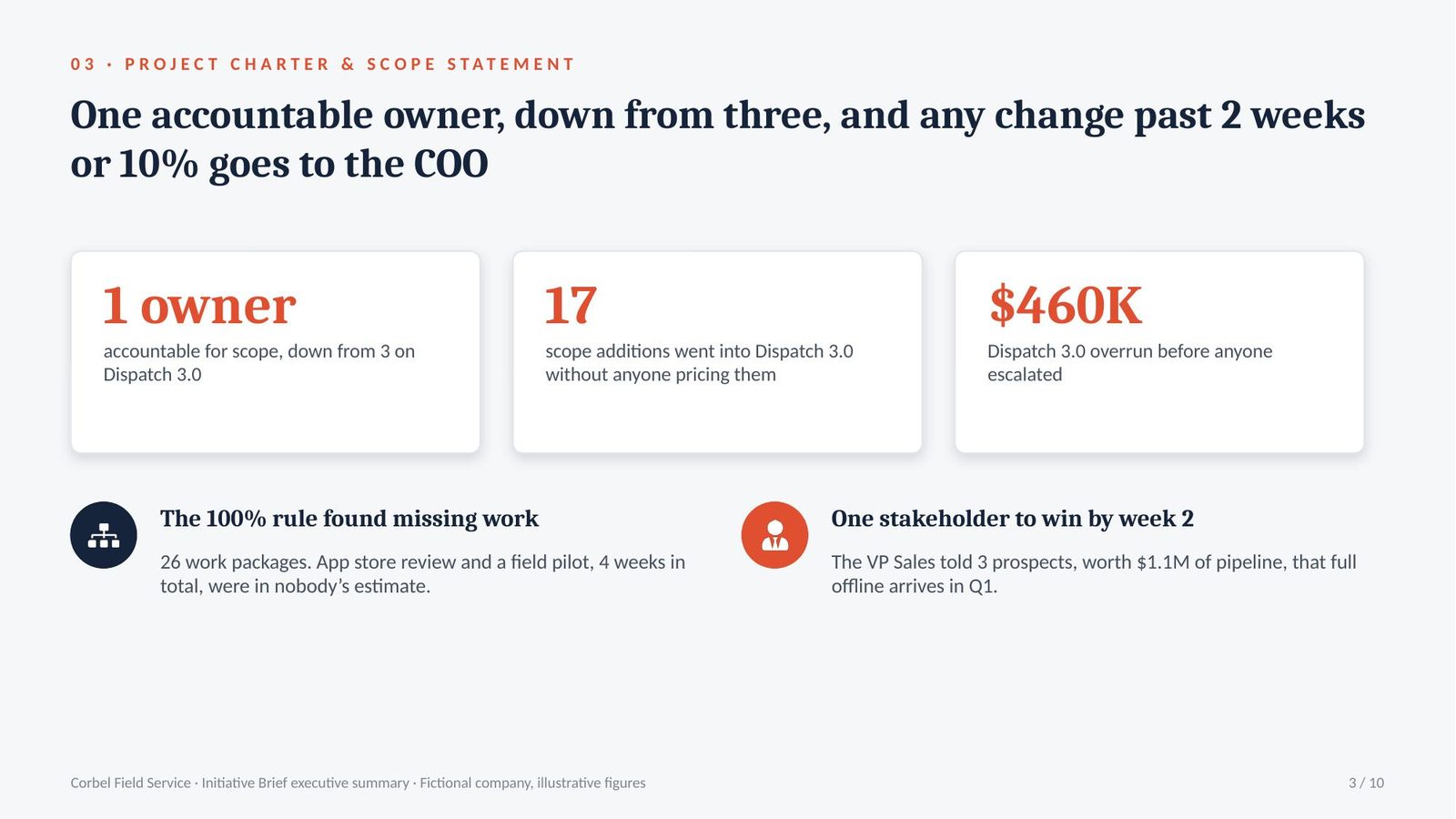

One sponsor, the COO, is accountable for scope, budget and release. Any change beyond 2 weeks or 10% of budget comes to her, not to the project manager.

Accountable for scope
3 people on Dispatch 3.0, now 1
Work packages
26, of which 3 are too vague to estimate
Tolerances
2 weeks, and 10% of the $1.4M budget
Most likely to derail
VP Sales, who promised full offline to 3 prospects

Takeaway: give each decision one accountable owner, and meet the VP Sales in week 1 to agree what can be promised to prospects.

The analysis · Dispatch 3.0’s $460K overrun began with three people allowed to add scope

A RACI chart names who is Responsible, Accountable, Consulted and Informed for each decision, and on Dispatch 3.0 three executives were each Accountable for scope, so 17 additions went in without anyone pricing them.

  • Tolerance sets the escalation point. The project manager can absorb up to 2 weeks and 10% of the $1.4M budget; beyond that the COO decides. Dispatch 3.0 drifted 11 weeks and $460K before anyone did.
  • The 100% rule found missing work. A work breakdown structure (WBS) splits the project into deliverables and work packages, and its 100% rule requires every level to add up exactly to the one above. Applying it turned up app store review and a field pilot: 4 weeks that were in nobody’s estimate.
  • One stakeholder has promised $1.1M of pipeline. On the power/interest grid, which places each stakeholder by influence over the project and how directly it affects them, the VP Sales is high on both: he has told 3 prospects, worth $1.1M, that full offline arrives in Q1. The project needs him on side by week 2.

Prompt 04 · Plan

Backlog Prioritisation: How Corbel Used It

What Corbel brought · VP Product

“212 requests, 14 engineers, and every one of them is urgent to somebody senior.”

What the prompt returned

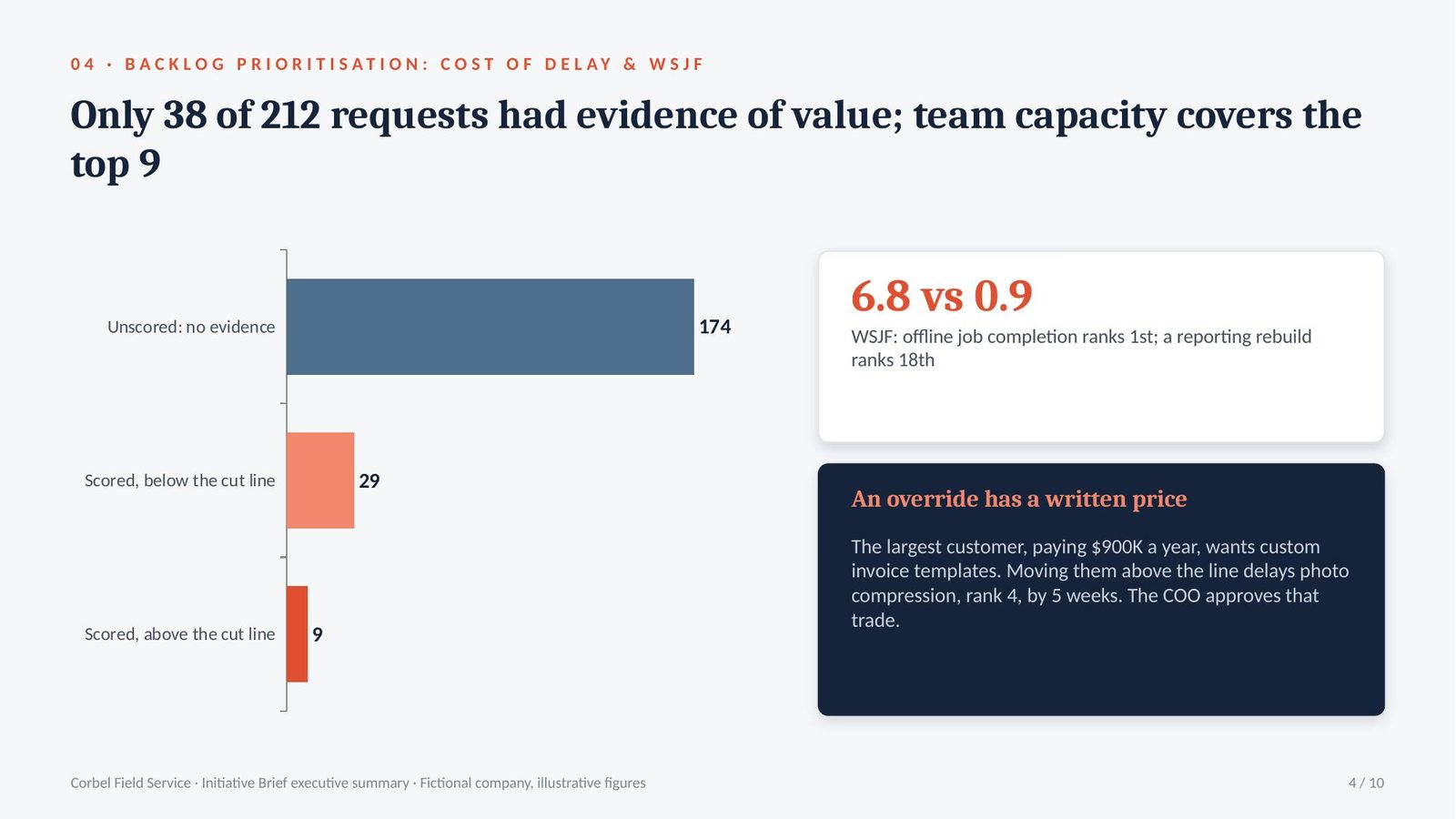

38 requests had evidence and were scored. Offline job completion ranks first. The cut line falls after item 9, and moving custom invoice templates above it delays item 4 by 5 weeks.

Scored with evidence
38 of 212; 174 listed as unscored
Rank 1
offline job completion, WSJF 6.8
Cut line
after item 9: 14 engineers for 12 weeks
Override requested
custom invoices, delays item 4 by 5 weeks

Takeaway: work to the cut line, and require the COO to approve any override together with its cost.

The analysis · 174 of 212 requests had no evidence of value, so none of them were scored

Cost of delay is what the business loses for each week an item waits, and weighted shortest job first (WSJF) divides it by the size of the job, which put offline job completion first at 6.8 and a reporting rebuild eighteenth at 0.9.

  • Most of the backlog was opinion. 174 requests had a requester but no usage data, revenue or support volume behind them. They are listed as unscored rather than given guessed numbers.
  • Capacity draws the line. 14 engineers over a 12-week quarter covers the top 9 items. The other 29 scored items are marked “not this period”. A RICE cross-check, which scores reach, impact, confidence and effort, agreed with the WSJF order on all 9.
  • An override has a written price. The largest customer, paying $900K a year, wants custom invoice templates. Moving them above the line pushes photo compression, rank 4, back 5 weeks, and the log names the COO as the person who approves that trade.

Prompt 05 · Plan

Product Roadmap Based on Results: How Corbel Used It

What Corbel brought · VP Sales

“Sales needs dates on everything, or we can’t sell any of it.”

What the prompt returned

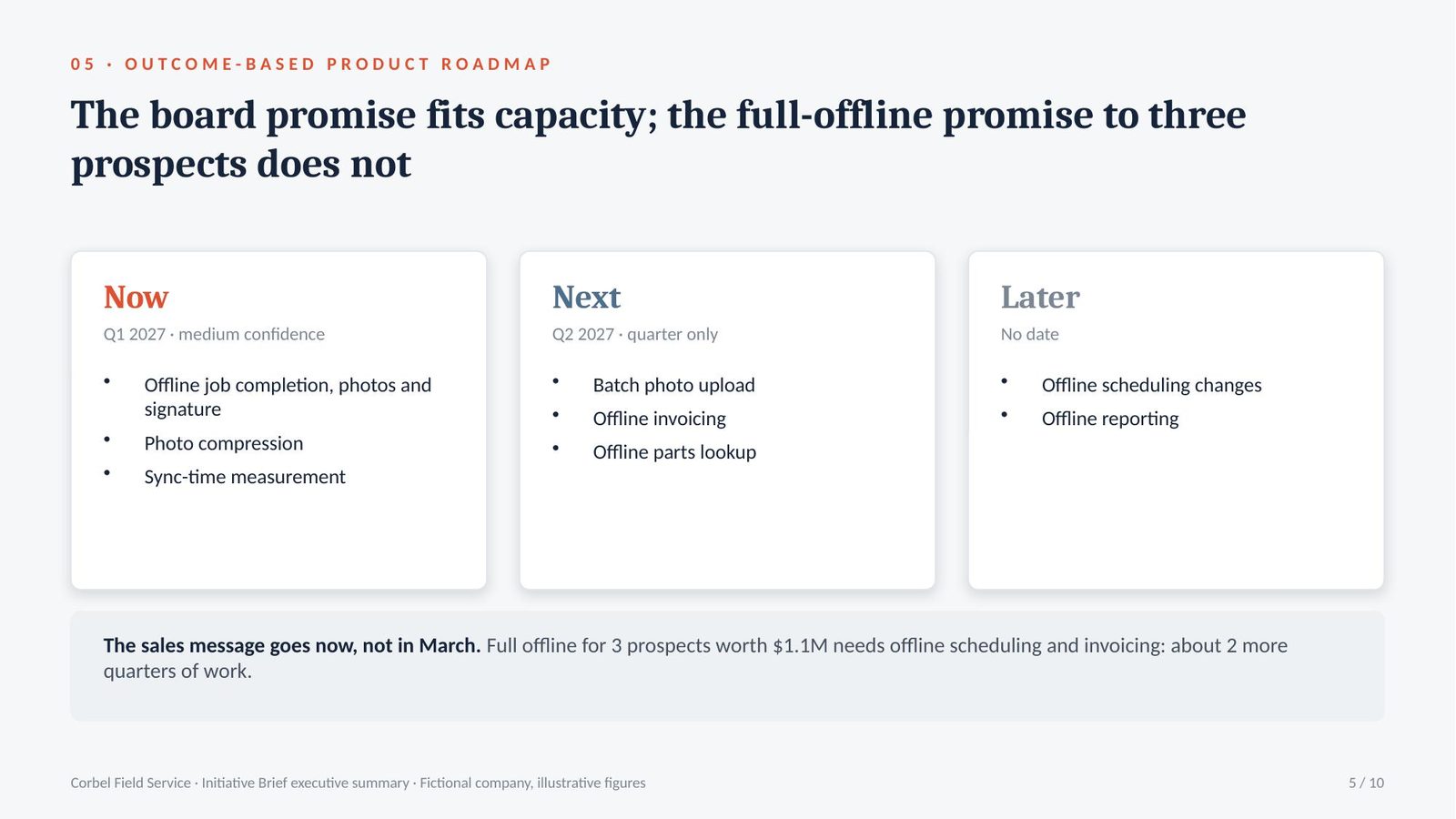

Now: offline job completion, Q1 2027. Next: offline parts lookup, Q2. Later: offline scheduling, no date. The board promise fits as scoped; the promise to three prospects does not.

Now
offline job completion, Q1 2027, medium confidence
Next
offline parts lookup, Q2 2027, quarter only
Board promise
offline in Q1 fits, scoped to job completion
Promise to 3 prospects
full offline in Q1 cannot be kept

Takeaway: date only the Now column, and tell the three prospects now that full offline is not in the Q1 release.

The analysis · One of Corbel’s two offline promises fits capacity; the other puts $1.1M of pipeline at risk

An outcome-based roadmap lists the results the company is trying to move rather than a calendar of features, and Corbel’s has three: fewer failed job completions, fewer cancellations that name offline, and faster invoicing at commercial HVAC accounts.

  • Confidence decides what gets a date. A Now / Next / Later roadmap groups work by level of commitment instead of by month: Now is in delivery, Next is being shaped, Later is a problem worth solving. Only the Now column carries a quarter with a stated confidence level. Next carries a quarter only, and Later, where offline scheduling sits, carries no date at all.
  • The board promise survives as scoped. A commitment check tests every promise already made against capacity. “Offline in Q1 2027” fits 14 engineers if it means job completion, the part supported by the 19% failure rate in the logs.
  • The sales promise does not. Full offline for 3 prospects worth $1.1M needs offline scheduling and invoicing, about 2 more quarters of work. The roadmap includes the message the VP Sales sends them now, not in March.

Prompt 06 · Plan

Project Schedule: How Corbel Used It

What Corbel brought · Engineering lead

“The board date is 31 March. Honestly, I have no idea whether that’s real.”

What the prompt returned

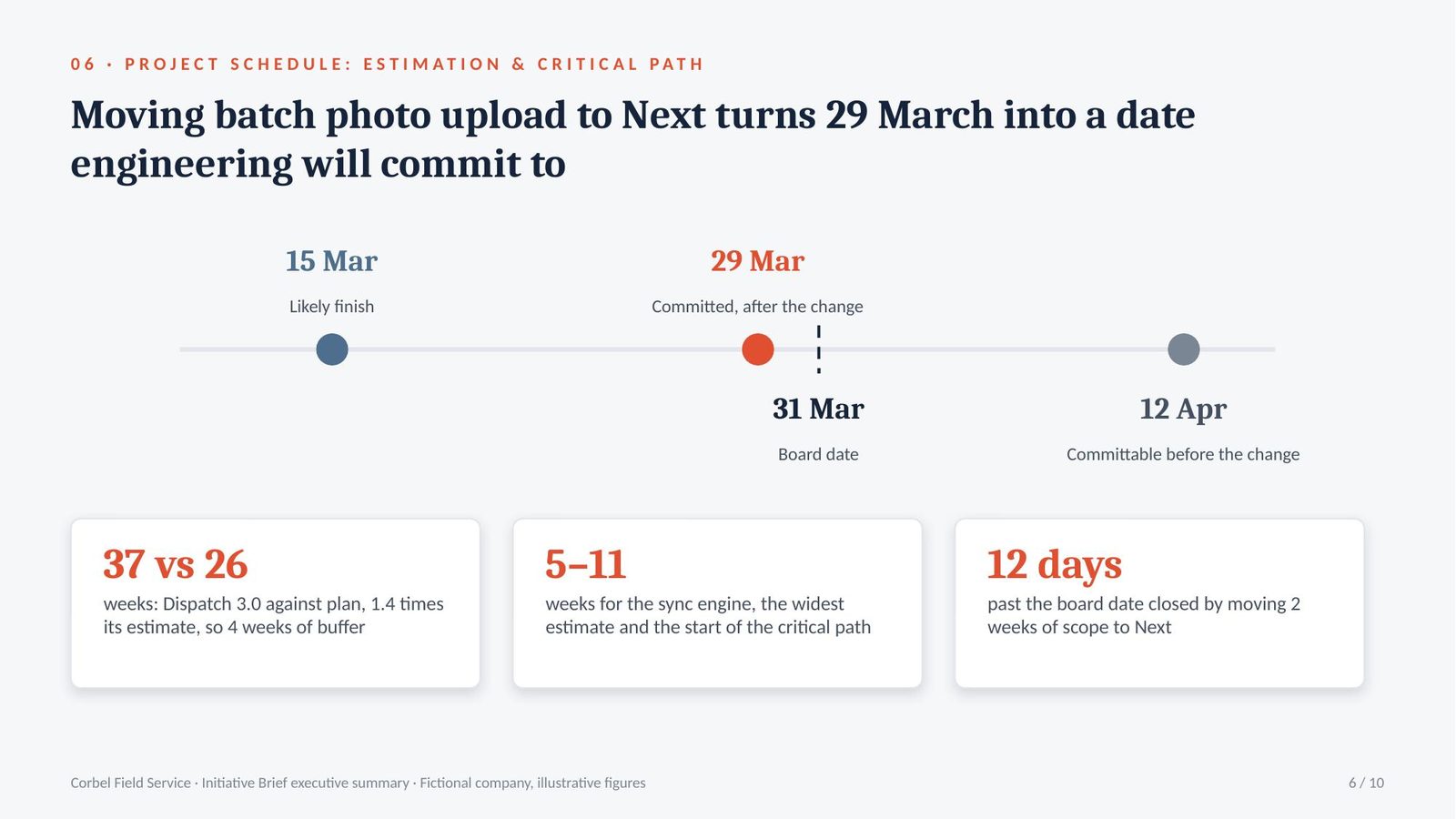

Likely finish 15 March 2027; a date safe to commit to is 12 April, 12 days past the board date. Moving batch photo upload to Next brings the committed date to 29 March.

Critical path
sync engine, conflict handling, field pilot, store review
Likely / committable
15 Mar 2027 / 12 Apr 2027
Past performance
Dispatch 3.0 took 37 weeks against 26 planned
Chosen
batch upload moves to Next; commit to 29 Mar 2027

Takeaway: commit to 29 March 2027 with batch photo upload moved to Next, and show the board the date as a range.

The analysis · The committable date missed the board by 12 days until one feature moved

The critical path is the longest chain of work in which each step waits for the one before, and Corbel’s runs through the sync engine, conflict handling, a field pilot and app store review, with no slack anywhere along it.

  • Three-point estimates show the spread. Each work package gets an optimistic, likely and pessimistic figure. The sync engine ranges from 5 to 11 weeks, the widest on the plan, which makes it the package to watch first. The dependency map, which records what each package waits on, puts it at the start of the critical path.
  • History sets the buffer. Dispatch 3.0 took 37 weeks against 26 planned, 1.4 times its estimate, so the committable date carries 4 weeks on top of the likely finish of 15 March.
  • Two weeks of scope closes a 12-day gap. Batch photo upload, sending more than 10 photos at once, is 2 weeks of work on the critical path. Moving it to Next makes 29 March a date engineering will commit to.

Prompt 07 · Control

RAID Log: How Corbel Used It

What Corbel brought · Tech lead, in a one-to-one

“If Priya leaves, nobody else understands the sync layer. And our pilot customers disappear in January.”

What the prompt returned

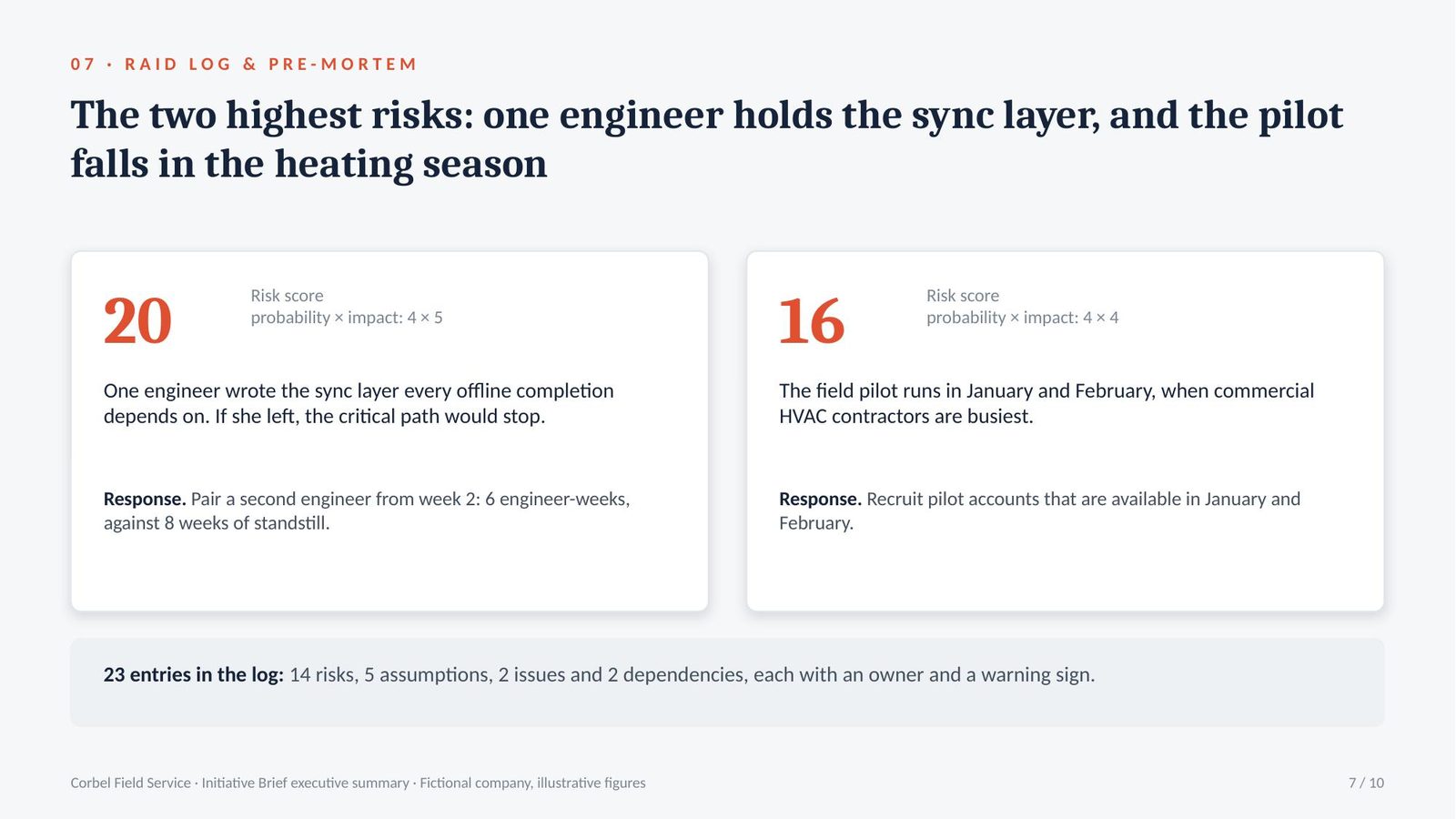

23 entries. Top risk: one engineer holds the sync layer, score 20. Second: the field pilot falls in the heating season, when contractors are busiest, score 16.

Log
14 risks, 5 assumptions, 2 issues, 2 dependencies
Top risk
one engineer holds the sync layer: 4 × 5 = 20
Pilot timing
heating season, January to February: 4 × 4 = 16
Response
pair a second engineer on the sync layer from week 2

Takeaway: pair a second engineer on the sync layer from week 2, and recruit pilot accounts that are available in January and February.

The analysis · Corbel’s two highest risks came from a one-to-one and a calendar

A RAID log tracks Risks, Assumptions, Issues and Dependencies in one place, and a pre-mortem fills it by imagining the project has already failed; Corbel’s produced 23 entries, and the two highest scores were things the team knew but had never written down.

  • One person is a single point of failure. Priya wrote the sync layer that every offline job completion depends on. If she left, the critical path would stop: probability 4 of 5, impact 5 of 5, a score of 20.
  • The pilot collides with the busy season. Commercial HVAC contractors are at full stretch in January and February, exactly when the pilot is scheduled. A pilot account that cannot spare the time scores 16 and would push the date.
  • Every response has a cost. Each high-scoring risk gets a response strategy: avoid, mitigate, transfer or accept. Mitigating this one by pairing a second engineer from week 2 costs 6 engineer-weeks, set against the 8 weeks the critical path would stand still while a replacement was hired and trained.

Prompt 08 · Control

Change Requests: How Corbel Used It

What Corbel brought · VP Sales, by email

“Northgate Mechanical will sign for $380K if offline invoicing is in the Q1 release. Can we just add it?”

What the prompt returned

New scope: offline invoicing is a written non-goal. 5 to 8 weeks of work, moving release from 29 March to 19 April and breaching tolerance. Recommended: defer to Q2 with a dated commitment to Northgate.

Classification
new scope, recorded as Won’t this release
Date impact
29 Mar to 19 Apr 2027, 3 weeks
Tolerance
2 weeks, breached: the COO decides
Recommendation
defer to Q2 with a dated commitment to Northgate

Takeaway: defer offline invoicing to Q2 with a written date for Northgate, and send the decision to the COO, because tolerance is breached.

The analysis · A $380K deal would have moved the board date without anyone deciding to move it

Change control prices every request before it is scheduled, and offline invoicing was already recorded in the requirements as Won’t this release, so it could only come in as a change with its cost attached.

  • The cost falls on the critical path. Classified as new scope, rather than a clarification or a defect, the request is priced in full. Invoices need the same conflict handling as jobs, which adds 3 weeks to the longest chain of work and moves release from 29 March to 19 April.
  • Three weeks breaches tolerance. Two changes approved earlier had already used 9 days. This one takes the total past the 2 weeks the project manager may absorb, so the decision goes to the COO.
  • Deferring still keeps the deal. Northgate’s peak is the summer cooling season, so a Q2 release with a written date still reaches its technicians in time. Approving it now moves the date for all 640 customers.

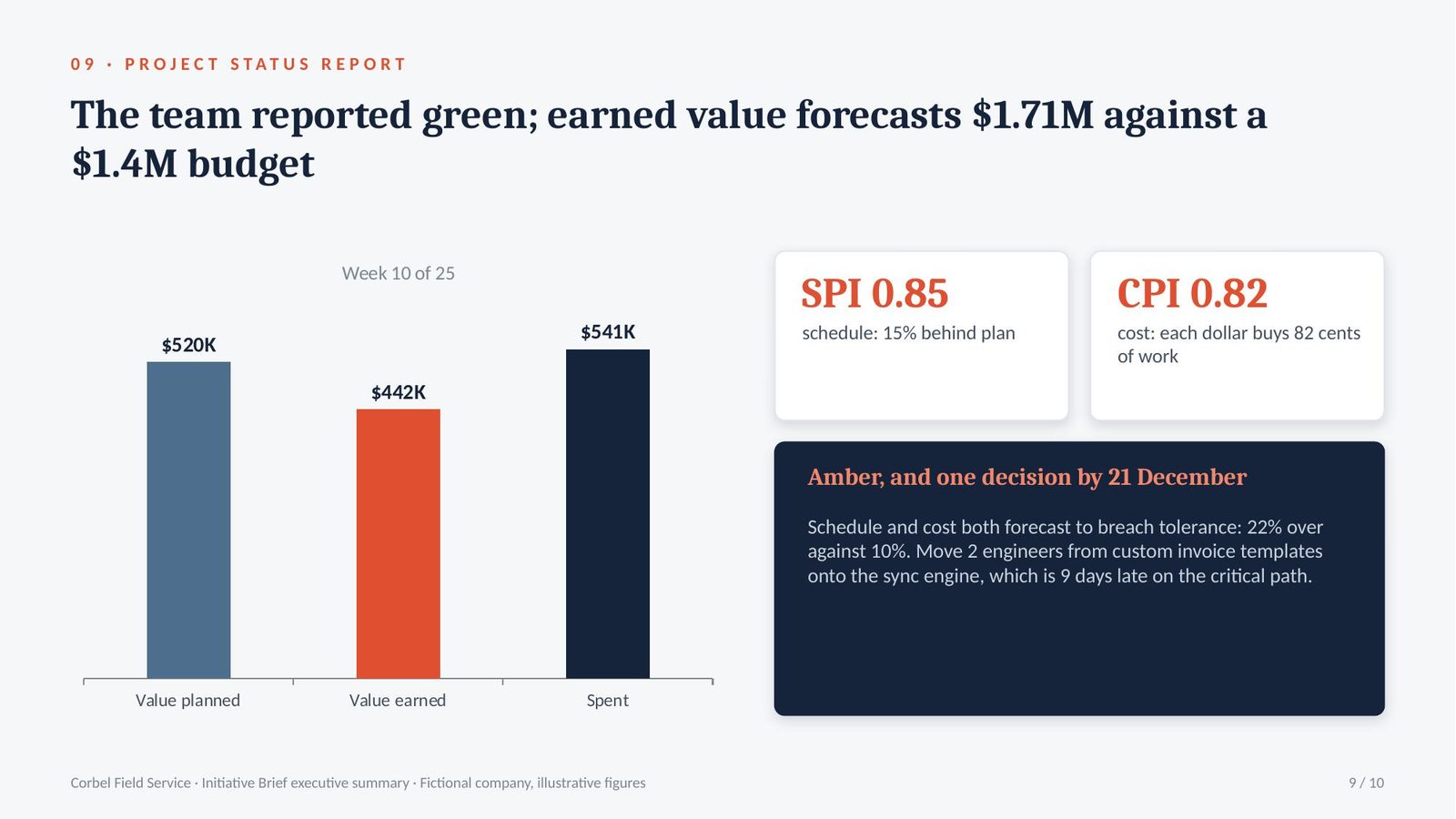

Prompt 09 · Control

Project Status Report: How Corbel Used It

What Corbel brought · Project manager

“We’re mostly on track. Maybe amber on one thing.”

What the prompt returned

Status: amber. Schedule and cost both forecast to breach tolerance. At a cost performance index of 0.82 the project finishes at $1.71M against $1.4M. Decision needed by 21 December.

Team’s colour
green overall
Earned value, week 10
SPI 0.85, CPI 0.82
Forecast cost
$1.71M against a $1.4M budget
Decision needed
move 2 engineers onto the sync engine by 21 Dec

Takeaway: report amber, and ask the COO to approve moving two engineers to the sync engine by 21 December.

The analysis · The report said green while the numbers forecast a $310K overrun

Earned value compares the work finished with the work planned and the money spent, and at week 10 Corbel had earned $442K of value against $520K planned while spending $541K.

  • Two ratios make it plain. The schedule performance index (SPI), value earned divided by value planned, is 0.85: 15% behind. The cost performance index (CPI), value earned divided by actual cost, is 0.82: each dollar buys 82 cents of work.
  • The forecast breaches tolerance. At a CPI of 0.82, the $1.4M budget finishes at $1.71M, 22% over against a 10% tolerance. Under the report’s RAG rules, where red, amber and green each map to a tolerance, that is amber now, and red on the day the breach happens.
  • The team’s green rating matched none of the rules. The sync engine, on the critical path, is 9 days late: the same kind of early slip Dispatch 3.0 reported as green before it finished 11 weeks late.

Prompt 10 · Launch

Go-Live Decision and Post-Launch Review: How Corbel Used It

What Corbel brought · Chief Operating Officer

“The pilot’s done and we’re ready to ship. Tell me honestly whether we should.”

What the prompt returned

Go, with two conditions: roll out to 20% of accounts first, and publish the support runbook for sync conflicts before day one. At 90 days, failed completions fell from 19% to 4.1%, short of the 3% target.

Readiness
11 of 13 criteria met; go with 2 named conditions
Primary metric at 90 days
19% to 4.1%; target of under 3% missed
Cause
no pilot account used older Android phones
Decision
keep investing: low-storage mode, under 3% by Q3 2027

Takeaway: report each release against its business case benefits and success metrics, not its launch date, and require future pilots to match the customers’ device mix.

The analysis · Corbel hit its date and its budget and still missed the metric by 1.1 points

A post-implementation review measures benefits realisation, whether a release delivered the benefits in its business case and the metrics in its requirements, rather than whether it launched on time, and Corbel launched on 29 March at $1.52M, inside its 10% tolerance, but moved failed job completions from 19% to 4.1% instead of under 3%.

  • No evidence counted as not met. 11 of 13 go/no-go criteria were met. The missing support runbook and 2 open severity-2 defects became named conditions with owners, not a reason to slip the date.
  • Five whys found a process cause. Five whys means asking “why” repeatedly until the answer is a process the company can change. The failures cluster at 31 accounts running Android phones older than 2021, which run out of storage for queued photos. The pilot was drawn from the 5 largest accounts, whose technicians all carry recent iPhones, and no rule required it to match the customer base.
  • The lesson changes a rule. Pilot selection must now match the customers’ mix of devices, owned by the head of product operations, and the next release adds a low-storage mode targeting under 3% by Q3 2027.
The finished files · from prompts 05, 09 and 07

The Finished Files: Product Roadmap, Status Report and RAID Log

The three documents Corbel’s COO received in December, produced by prompts 05, 09 and 07: the roadmap after change control, the week-10 status report, and the top of the RAID log.

Offline programme roadmap

Three outcomes, one board promise, dates only where confidence has earned them

Corbel Field Service
After change control, Dec 2026

Outcome 1

Failed job completions at commercial HVAC accounts

19% → under 3%

Outcome 2

Cancellations that name working offline

48 a year → under 20

Outcome 3

Days from job completion to invoice

4.2 → under 1

Now Q1 2027 · medium confidence

Offline job completion, photos and signature

Outcomes 1, 3 · release 29 Mar 2027

Photo compression

Outcome 1 · WSJF rank 4

Sync-time measurement

Baseline requirement in the BRD

Next Q2 2027 · quarter only

Batch photo upload

Moved from Now to protect the date

Offline invoicing

Outcome 3 · written commitment to Northgate

Offline parts lookup

Outcome 1

Later no date

Offline scheduling changes

Evidence: Reported only

Offline reporting

Evidence: Reported only

Not doing this year, and what sales can say

“Full offline mode” for every feature: no failure data outside job completion. Sales message to the three prospects sent in October, not March.

Offline programme — status report

For the COO · one page

Week 10 of 25
14 December 2026

Overall

Amber

Two tolerances forecast to breach

Schedule

Amber

Forecast 14 Apr vs tolerance 12 Apr

Cost

Amber

Forecast +22% vs 10% tolerance

Scope

Green

2 changes, 9 days, within 2 weeks

What changed. The sync engine, on the critical path, is 9 days late, and the project is buying 82 cents of work for each dollar spent.

What it means. At this rate the release is delivered on 14 April 2027 at $1.71M, past both the 2-week and the 10% tolerance.

Decision needed by 21 December. Move 2 engineers from custom invoice templates to the sync engine. Cost: the templates move to Q2 for the $900K customer.

MeasurePlannedActualReading
Milestones reached32Sync engine prototype missed
Value of work finished$520K$442KSPI 0.85 · 15% behind
Spend to date$520K$541KCPI 0.82 · 82 cents per dollar
Forecast cost at completion$1.40M$1.71M$1.4M ÷ 0.82

Colour check. The team reported green. The rules give amber on schedule and cost; the colours above are the restated ones.

RAID log — top five

Risks, assumptions, issues and dependencies leadership needs to see

23 entries in total
Reviewed weekly

IDEntryScoreTriggerOwner · response
R1Because one engineer wrote the sync layer, her leaving would stop the critical path20Any sync change reviewed by her aloneEngineering lead · pair a second engineer from week 2
R2Because the pilot falls in the heating season, pilot accounts may not give it time16Fewer than 4 of 5 accounts confirmed by 15 JanHead of customer success · recruit 8 accounts, 3 of them plumbing contractors
R3Because iOS limits background activity, jobs may not sync until the app is reopened15Background sync test fails beyond 10 minutesiOS lead · sync on reopen, tested on 4 iOS versions by week 6
A1Contractors accept a signature captured offline as proof of completion–Confirm with 5 accounts by 30 NovHead of product · validate in pilot contracts
D1Apple and Google app store review, 5 to 10 days–Submission not ready by 1 Mar 2027Release manager · on the critical path

Prompt output, formatted for this page. In Claude each prompt returns it as a finished Word or Excel file; other tools return the same content as text and tables. The figures come from whatever you paste in. Corbel is fictional, so every number here is ours to show you.

Project Management AI Prompts: Frequently Asked Questions

Can ChatGPT write a product requirements document (PRD)?

Yes. The requirements prompt documents the business rules, the functional and non-functional requirements and the acceptance criteria that IT or a product team builds from. In Claude, the PRD comes back as a Word document.

What is a RAID log?

A RAID log tracks a project’s Risks, Assumptions, Issues and Dependencies. The RAID prompt finds what could make the project fail while it is still cheap to fix, and gives each risk an owner and a warning sign.

Can ChatGPT write a project status report?

Yes. The status report prompt gives leaders a red, amber or green status based on clear rules, the numbers behind it and the one decision needed.

Which AI tools do the project management prompts work with?

ChatGPT, Claude and Gemini. In Claude, every prompt ends with a finished Word or Excel file. ChatGPT and Gemini return the same content as text and tables.

Pack 5 · Product & Project Management

Get the Project Management AI Prompt Pack

  • Business case, requirements (BRD / PRD) and project charter
  • Cost of delay prioritisation, roadmap and critical path
  • RAID log, change control and project status report
  • Go-live decision and post-implementation review
  • Text file and formatted PDF · ChatGPT, Claude and Gemini
  • Every prompt ends in a finished Word or Excel file in Claude

* Corbel Field Service, its people, customers and all figures on this page are fictional and used for illustration only. Output from these prompts depends on the information you supply and the AI tool you use.

Next step · the AI PowerPoint generator

Turn the Finished Documents into a Board Presentation

Paste the pack’s documents into the AI PowerPoint generator, a separate product at $19, and Claude builds the board presentation as a real .pptx file with editable PowerPoint charts.

Below is Corbel’s executive summary: ten slides, one for each prompt’s output, unedited.

Corbel Field Service executive summary, slide 1 of 10 Corbel Field Service executive summary, slide 2 of 10 Corbel Field Service executive summary, slide 3 of 10 Corbel Field Service executive summary, slide 4 of 10 Corbel Field Service executive summary, slide 5 of 10 Corbel Field Service executive summary, slide 6 of 10 Corbel Field Service executive summary, slide 7 of 10 Corbel Field Service executive summary, slide 8 of 10 Corbel Field Service executive summary, slide 9 of 10 Corbel Field Service executive summary, slide 10 of 10
1 / 10

Corbel Field Service is fictional, so every number here is ours to show you. Generated in the NOVA house style.

Microsoft PowerPoint Want the presentation built for you? The AI PowerPoint Generator — $19

Built in Claude as a real .pptx file with editable charts. Or take both generators together in the bundle, $25.

More AI Prompts for Work

Nine packs for work, from strategy and finance to sales, HR and operations, each written to the same standard with its own worked example.
