Process Mapping: SIPOC & Value Stream Map
Maps the process as it runs today, step by step, and shows how much of the elapsed time is work and how much is waiting.
What Brennock brought · COO
“Nobody can tell me where an order spends its two days.”
What the prompt returned

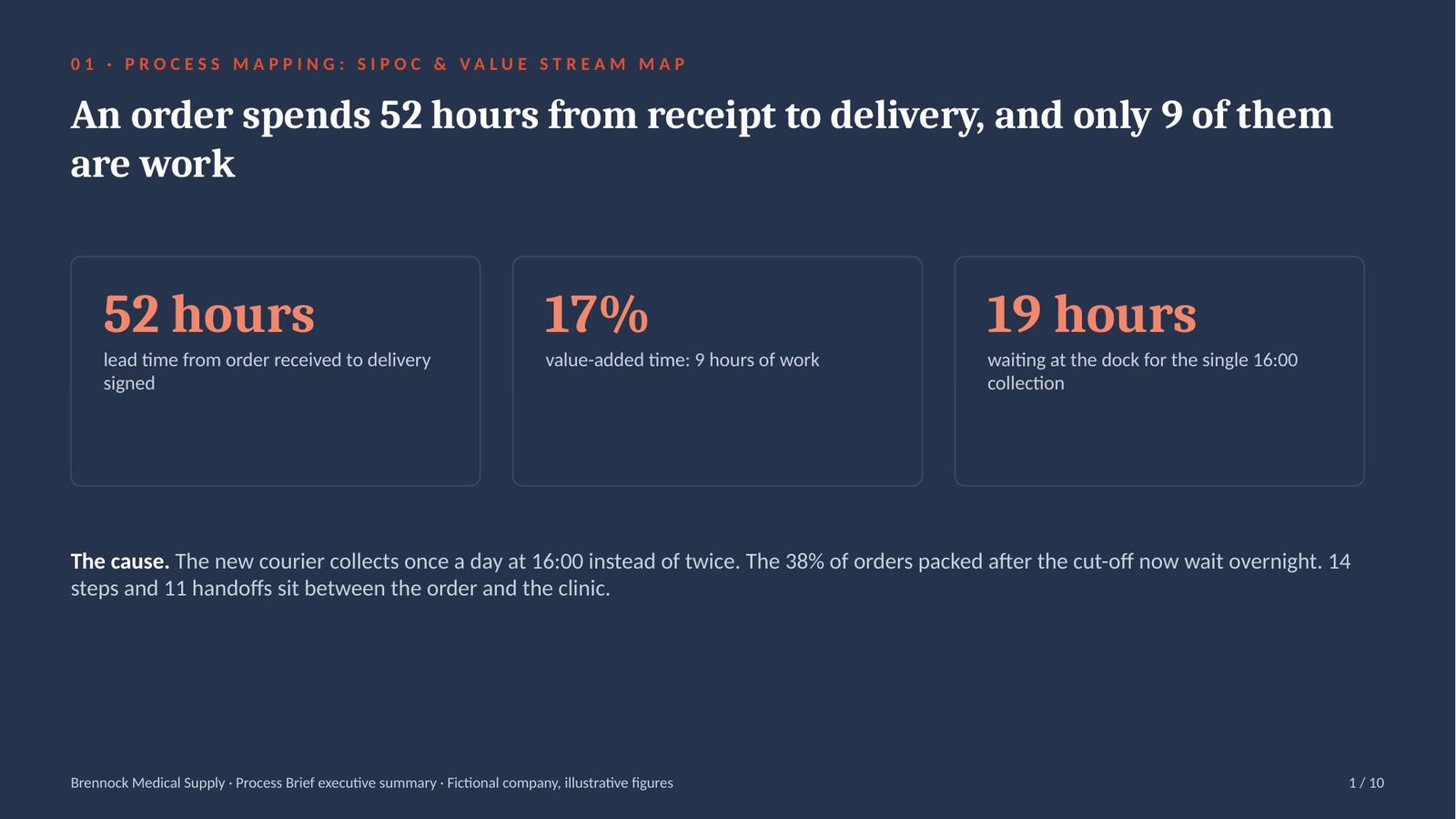

14 steps and 11 handoffs from order to delivery. Of 52 hours of lead time, 9 are work; the longest wait is 19 hours for the single 16:00 courier collection.
The analysis · 83% of an order’s time is spent waiting, most of it for one collection
A SIPOC lists the suppliers, inputs, process steps, outputs and customers of a process on one page. A value stream map adds the time each step takes and the time spent waiting before it, so the delay can be located.
- 9 hours of work, 52 hours elapsed: value-added time is 17% of lead time. The other 43 hours are queues between steps, and that is where the delivery promise is lost.
- 19 hours at the dock: the old courier collected at 11:00 and 16:00; the new one collects once, at 16:00. Orders packed after the cut-off, 38% of them, now wait overnight.
- 11 handoffs: the order passes between customer service, the warehouse, quality and the courier eleven times, and address changes are keyed in twice.
Takeaway: measure the waiting time between steps, not only the work, and start with the 19-hour wait for the single courier collection.
